SUMMARY VILLAGE REPORT
ON
KYNTON SA-IR VILLAGE
PYNURSLA
EAST KHASI HILLS DISTRICT
DISTRICT PROJECT MANAGEMENT UNIT (DPMU)
The Government of Meghalaya has launched its flagship program, the Integrated Basin Development Project (IBDLP) in 2012. IBLP is a citizen-centric and demand-driven program that focuses on the development of community participation and capacity building as the pathway to sustainable eco-systems development.
Nestled under IBDPL, the Community Led Landscape Management Programme of the Government of Meghalaya looks at natural resources management through a community-led landscape approach. The Community-Led Landscape Management Project (CLLMP), which receives support from the World Bank, is a part of the CLLM-Programme.
The project interventions will include preparation of community led natural resource management plans. The CLLMP has the following three components:
Strengthening Knowledge and Capacity of Communities for Natural Resources Management
Community-Led Landscape Planning and Implementation
Project Management and Governance
Objective:
“To manage and conserve the natural resources, especially forests, soil and water sources, in a manner that supports the financial and physical well-being of communities in the state”
Scope:
The CLLM-Programme is focused on enhancing the capacities of communities and traditional institutions (TI) through the use of a landscape approach to manage their natural resources, such as soil, springs and other water sources, forests, and bio-diversity.
The project will be planned and implemented in about 400 villages across the state.
The CLLMP places a significant emphasis on establishing local institutions by providing systematic capacity-building in both technical and social skill areas.
The project will also provide such training to communities outside of the villages that are being targeted and will aid those communities in their attempts to obtain money from other rural and natural resources projects and programmes.
By creating and following efficient systems and procedures and utilising the right technology, the programme will also make an investment in enhancing the delivery of the process and results.
Benefits:
Benefits for community (Skills and Capacity relating to technical and managerial areas like NRM and Conflict resolution.
Traditional institutions (village councils, traditional leaders, community-based organisations, SHGs, etc.) gain from knowledge sharing, the promotion of innovative approaches, access to technology, technical managerial support, and financial assistance.
The project is expected to have an impact on approximately 1 lakh partners, half of whom are women and rely on land, forests, and agroforestry.
A total of 400 communities will benefit from the project's efforts, which will ensure that the 55000 Ha of the targeted area has access to water, biological resources, and productive soil. The project's outcomes can be summed up as follows.
Implementation Agency:
The Project will be executed by the MBMA in collaboration with other partners particularly, SIRD (for training and capacity building), Department of Soil and Water Conservation, Water Resource Department, Forest Department, specifically with respect to technical inputs, safeguards management and Community NRM plan preparation.
Project Period:
2018-2023 (5 years)

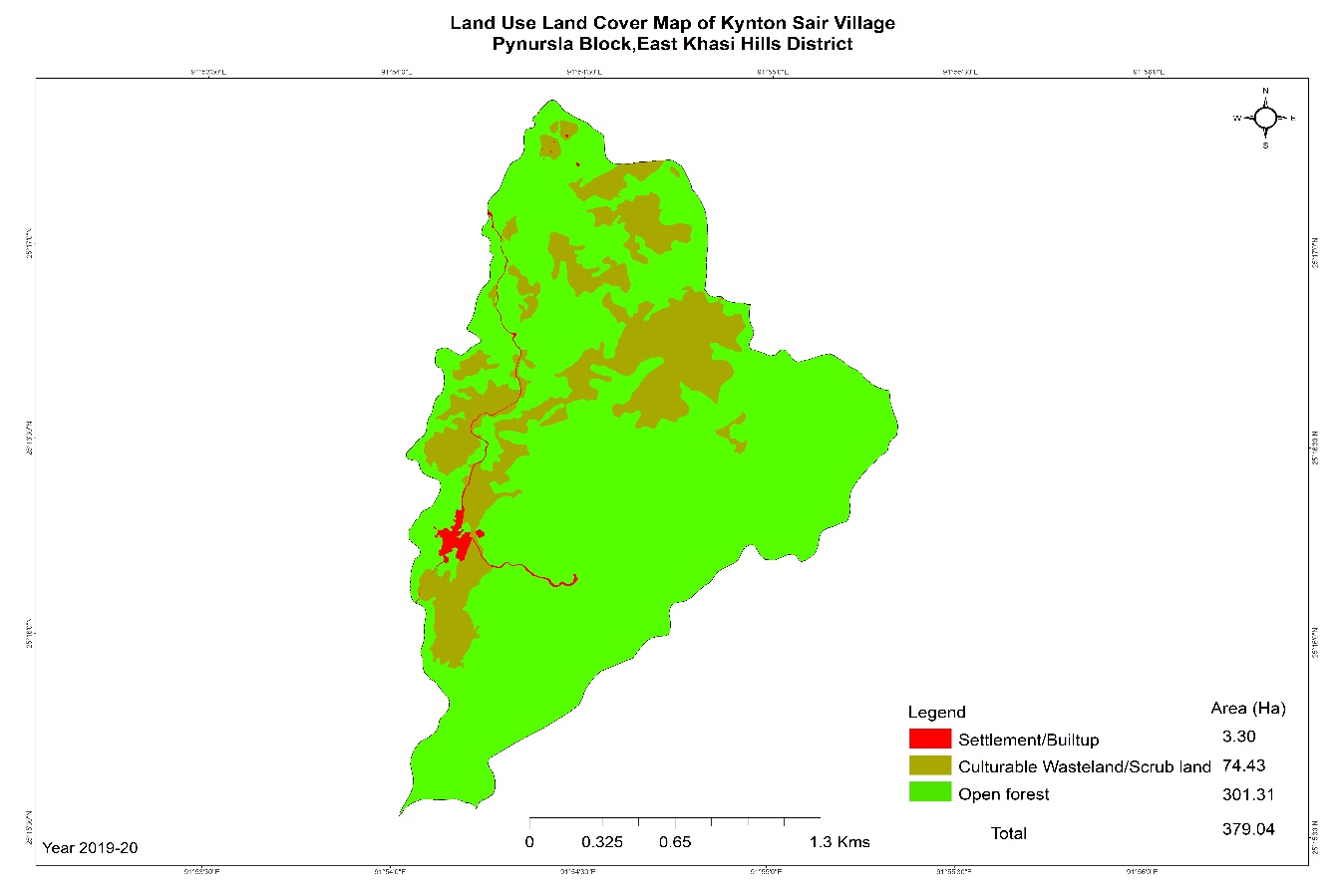

About the Village:

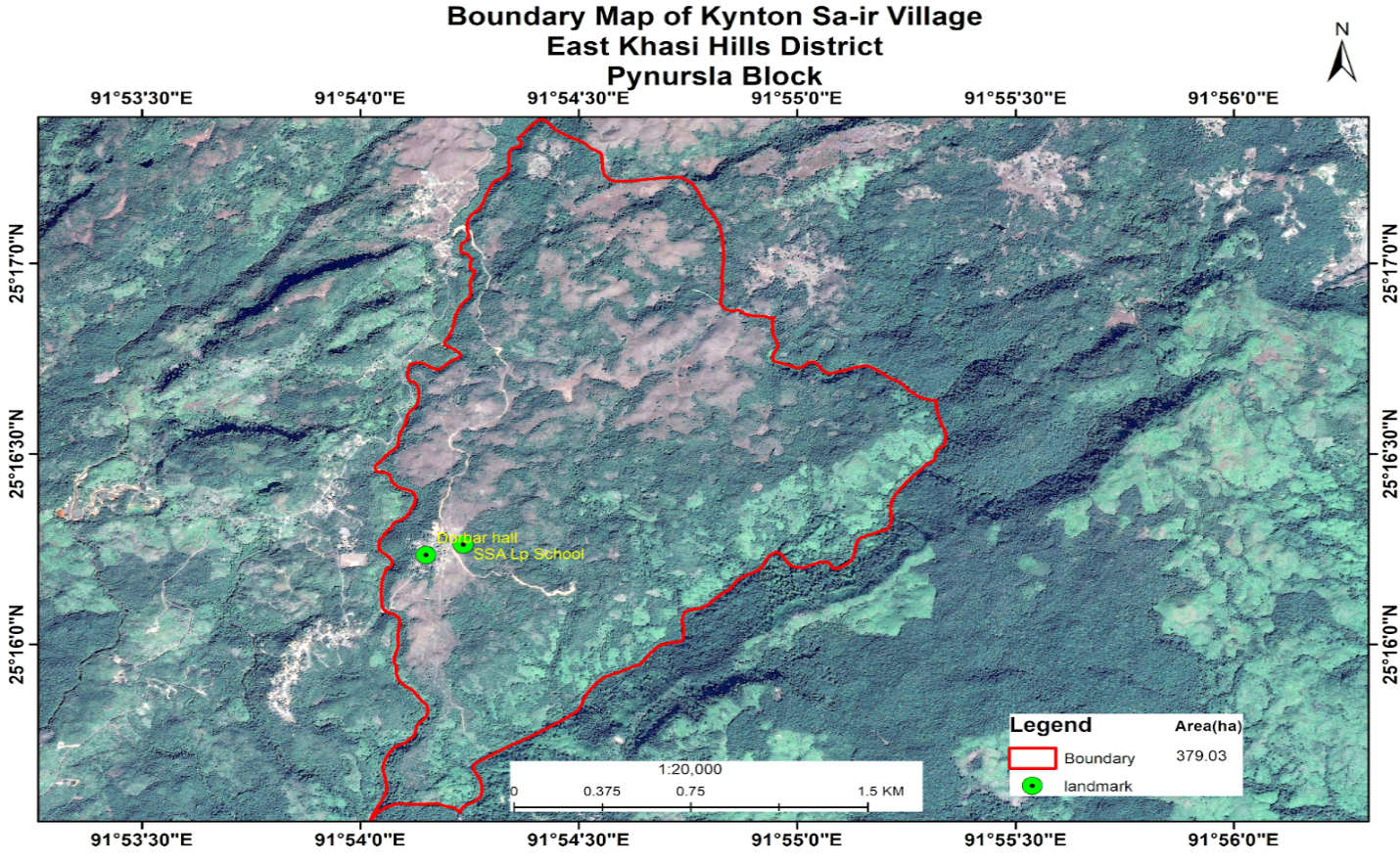

Kynton Sair VNRMC is one of the 92 villages in East Khasi Hills District selected for the implementation of CLLMP. It falls under Pynursla Block, East Khasi Hills 793110. The distance from Kynton Sair to the district headquarters (Shillong) is 57 km and to the Block office is 7 km. The geographical area of this village is 379.03 Ha. The total number of households in this village is 33 HH with a total population of 166 out of which, 86 are females and 80 are males.
Village Demography:
The number of households in this village is 33 with a population 166 people.
Age Group (In years) | Males | Females | Total |
---|---|---|---|
0-4 | 13 | 14 | 27 |
5-14 | 27 | 25 | 42 |
15-30 | 13 | 11 | 24 |
30-60 | 20 | 31 | 51 |
Above 60 | 7 | 5 | 12 |
Total | 80 | 86 | 166 |
The main occupation of this community is broom cultivation which widely adopted by majority of the households. Other occupations adopted in this community are daily wage labour and teaching profession.
Occupations | HHs | |
---|---|---|
i | Broom Cultivation | 25 |
ii | Labour | 5 |
iii | Teaching | 3 |
Fuel Type Used:
Fuel Type | No. of HH | |
---|---|---|
i. | Firewood | 33 |
Village Natural Resource Management Committee Members:
Sl No | Name | Gender (M/F) |
Age | Education | Designation | Contact No |
---|---|---|---|---|---|---|
1 | Standling Suting | Male | 36 | Diploma | Chairman | 9774248394 |
2 | Phindarishisha Khonglam | Female | 25 | MA | Secretary | 8259038647 |
3 | Thiak Khongstaing | Male | 53 | II | Treasurer | 9774810309 |
4 | Maphanglin Khangsam | Female | 26 | HSSLC | Member | 6009974148 |
5 | Bandalin Buhphang | Female | 28 | VI | Member | 9774877684 |
6 | Rison Khongthaw | Male | 21 | VIII | Member | No contact number available |
7 | Tohhok Khongthohrem | Male | 24 | I | Member | No contact number available |
8 | Byrno Khengram | Male | 40 | I | Member | No contact number available |
9 | Wingsor Khonglam | Male | 34 | III | Member | No contact number available |
Village Community Facilitators Members:
Sl No | Name | Gender (M/F) |
Age | Education | Area of Specialization | Contact No |
---|---|---|---|---|---|---|
1 | Nashailin Khongsam | Female | 25 | X | Environment and GIS | 6009966516 |
2 | Biangnam Suting | Female | 25 | VIII | Social & KM | 8787636951 |
3 | Rapborlang Khongtiang | Male | 19 | IX | M&E, Procurement | 9863113837 |
Important Dates & Events
The DPMU team visited Kynton Sair on 14th October 2020 to conduct a sensitization cum awareness program.
The Village Natural Resource Management Committee (VNRMC) was formed on 21th October 2020.
The Community Natural Resource Management Plan (CNRMP) was submitted on the 1st July 2021.
The Purchase Committee was formed on 21st October 2020.
On 21th October 2020, the Citizens Green Charter (CGC) was signed.
On 28th December 2020, the Expression of Interest (EOI) was signed.
On 28th December 2020, the Village Grant Agreement was signed.
Problem Analysis
Problem analysis involves identifying the overriding problem and establishing the causes and effects related to that problem. The FGD conducted with the participants to establish the problems faced by them reveals the following information.
Do people have sufficient access to supply of fodder, fuel wood, leaf litter?
Yes, sufficient supply.
Has access to timber improved or reduced over the years? How is access for household use and commercial use managed?
Yes, they have reduced over the years with increasing population.
Are the water bodies facing any threats?
Sometimes. Soil erosion that arise through road construction have led to siltation of water bodies.
Do all people in the village have access to drinking water? What are the challenges?
Yes, but we do face the problem of water scarcity during winters
Are there degraded areas in the village (open/ degraded forests, mining affected, high soil erosion etc.)?
No, there are no degraded forests in the village.
What has caused this degradation? Are there practices causing threats to availability and access to natural resources?
There is possibility for land degradation due to timber as firewood is the main type of fuel we use
What have been the changes in agricultural practices?
No, we practiced the same method of agriculture
Are there any challenges in farming?
Yes, due to water scarcity there is not enough water for watering the fields making the soil very infertile and affecting land productivity.
Purpose of Intervention
Prior to the CLLMP, it was found that soil erosion, land productivity and scarcity of water, were some of the major problems prevailing in Kynton Sair village. Therefore, the following interventions were implemented to control soil erosion, increase land productivity and reduce water scarcity.
The interventions implemented through CLLMP are:
Sr. No. | Name of intervention | Site Name | Start Date | Completion Date | Amount from CLLMP |
---|---|---|---|---|---|

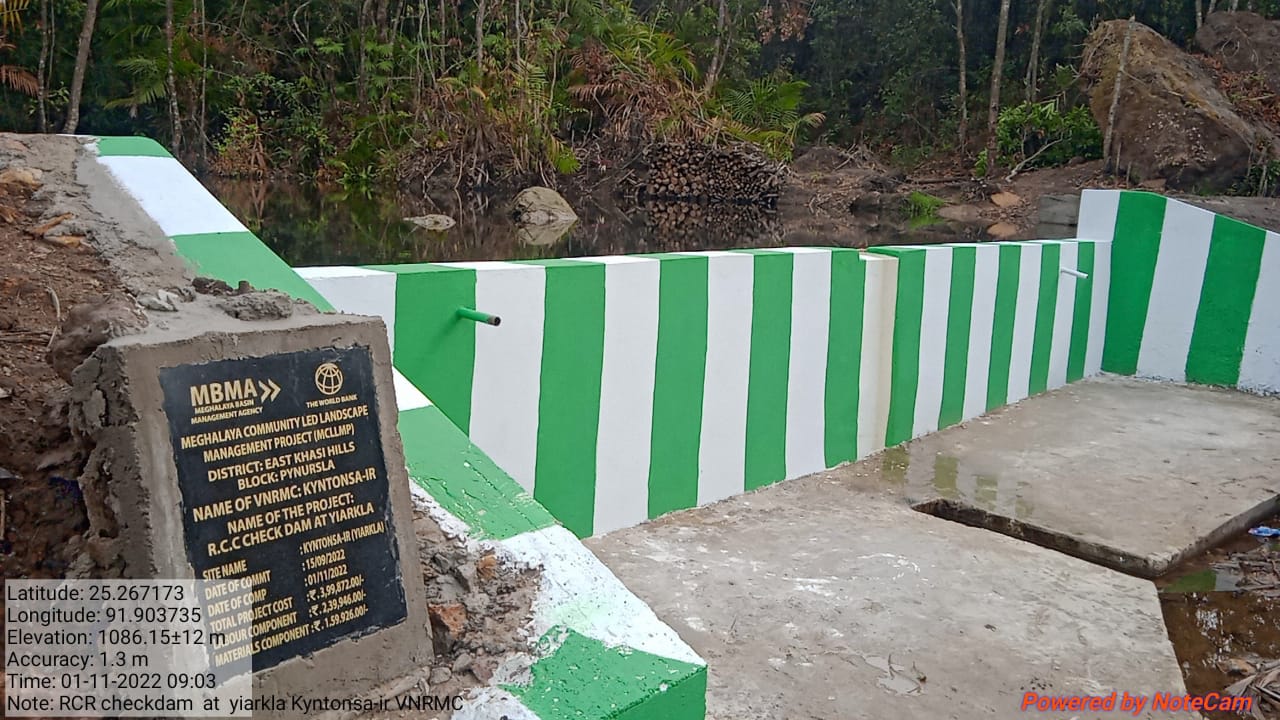

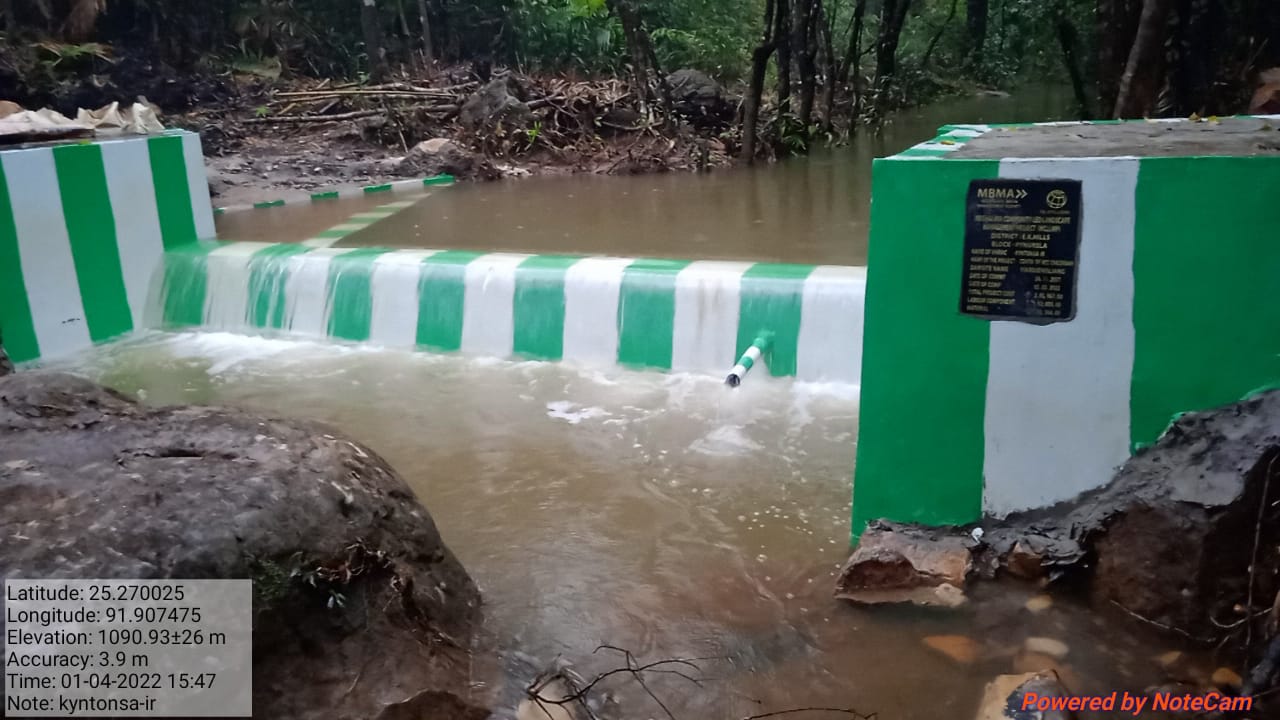

1. | RCC Check dam | Wah eir Dieng Liang | 29-Nov-21 | 05-Mar-22 | 2,95,967 |

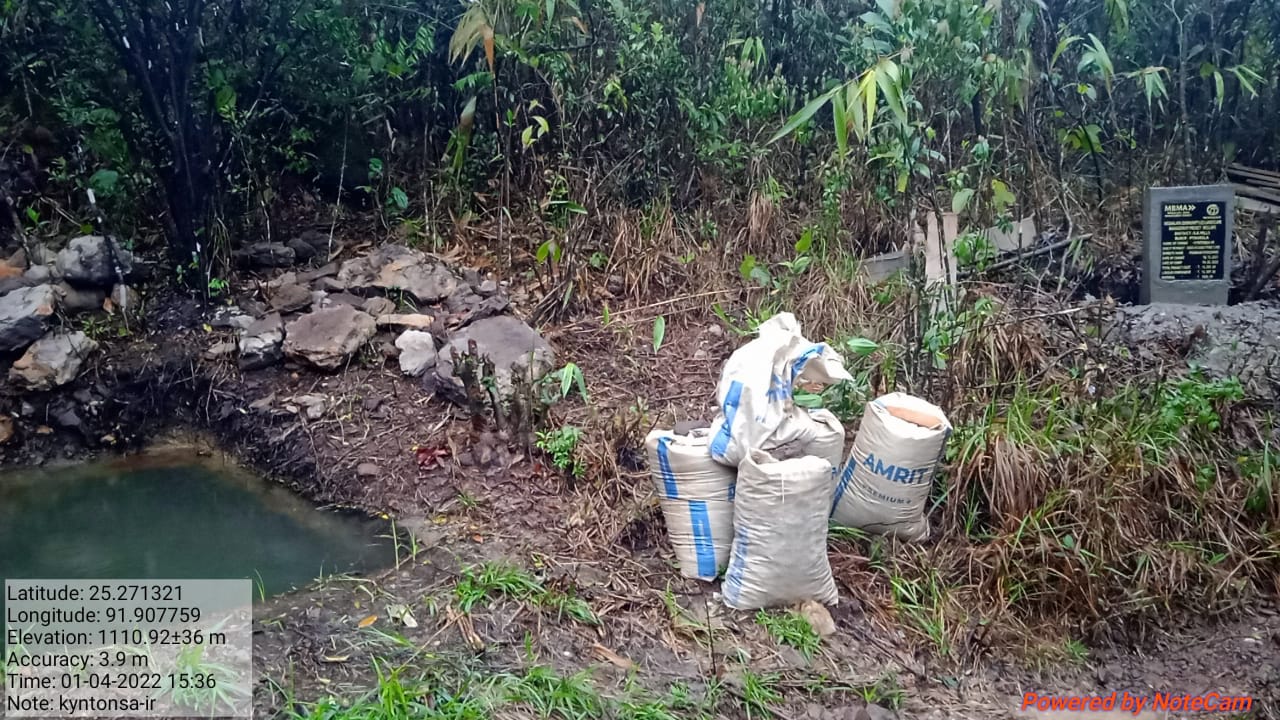

2. | Dug out pond | Eir Poh Mawrang Shkei | 18-Dec-21 | 04-Mar-22 | 19,507 |

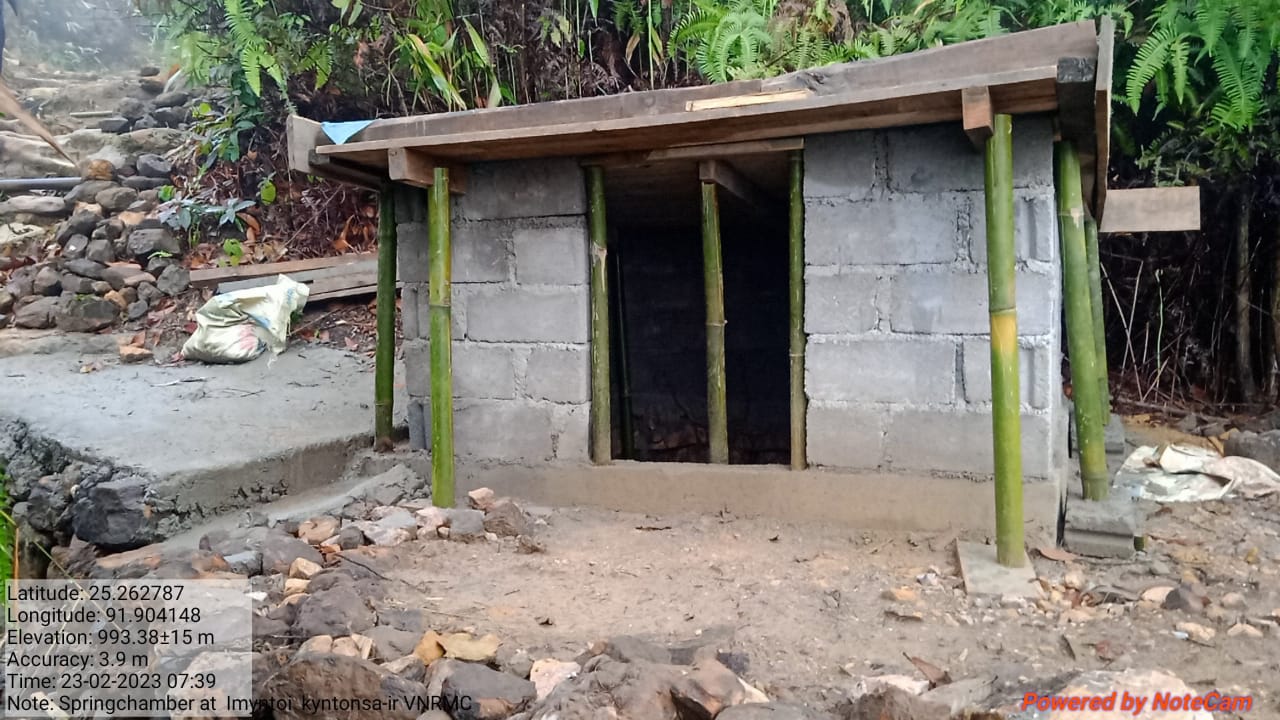

3. | Spring chamber | Imyntoi | 11-Nov-22 | Ongoing | 78,248 |

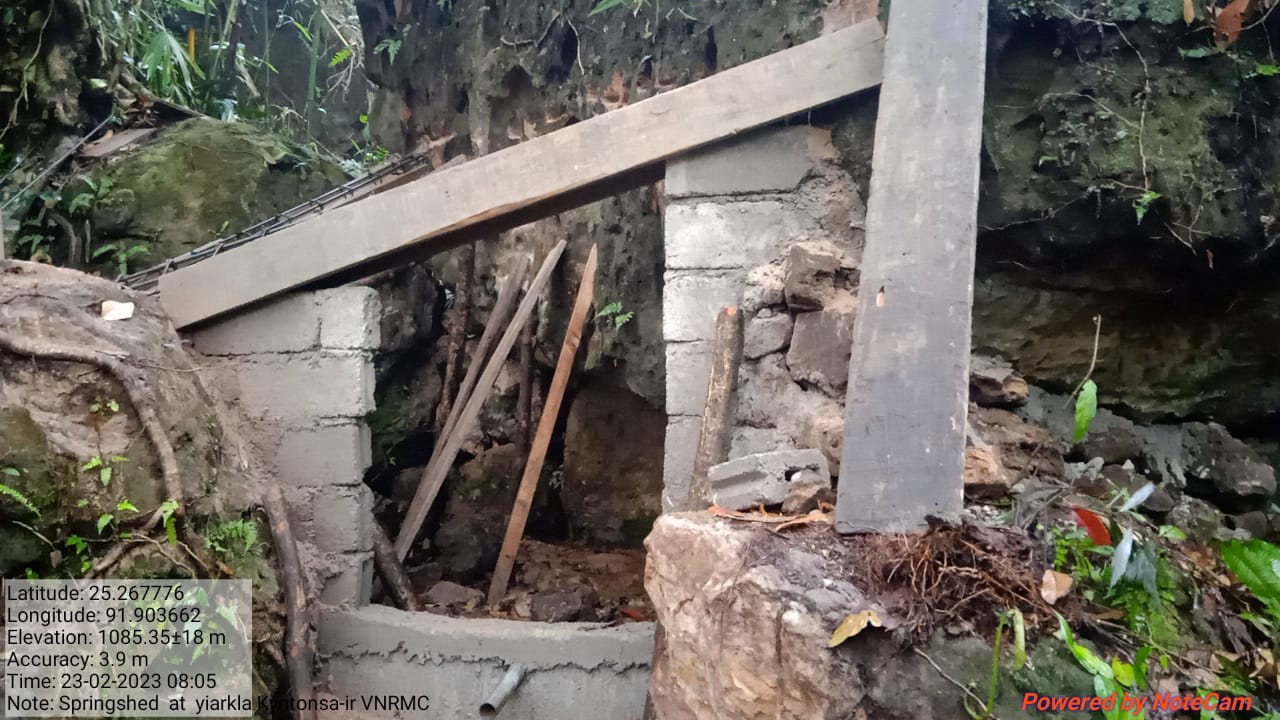

4. | Spring shed | Yiarkla | 2-Nov-22 | Ongoing | 54,276 |
5. | RCC Check dam | Dopjarait | Yet to start | 2,10,310 | |
6. | RCC Check dam | Yiar Shrieh | 2-Nov-22 | Ongoing | 3,21,200 |
7. | RCC Check dam | Wahdopjarait | Yet to start | 6,63,780 | |
8. | Community Nursery | Rumkpermasi | Yet to start | 1,29,917 | |

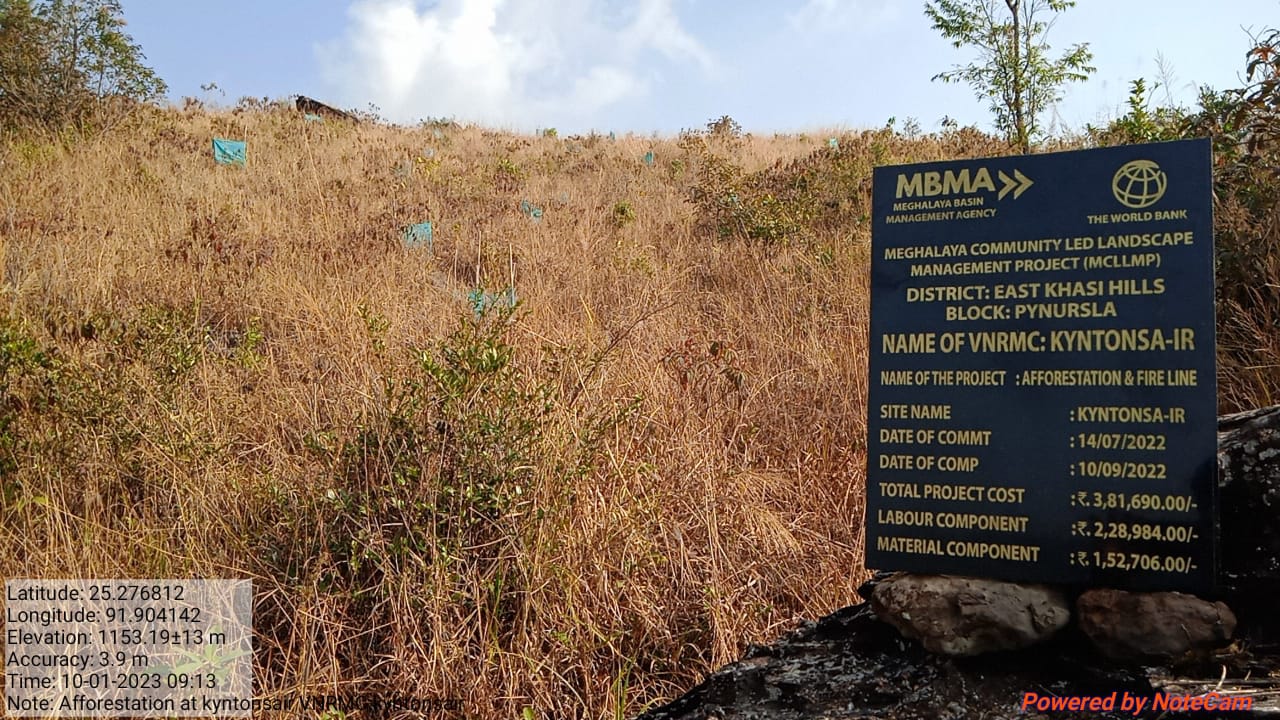

9. | Afforestation | Kynton saiir | 14-Jul-22 | 10-Sep-22 | 3,81,690 |
10. | Seed bank | Jakhoit | 2-Jan-23 | Ongoing | 1,00,000 |
11. | RCC Check dam | Yiarkhla | 15-Sep-22 | 1-Nov-22 | 3,99,872 |
12. | Bed raising compost | Kperingmasi | Yet to start | 16,000 | |
13. | Dug out pond | Kliar iar tngaw | 2-Jan-23 | Ongoing | 1,31,942 |

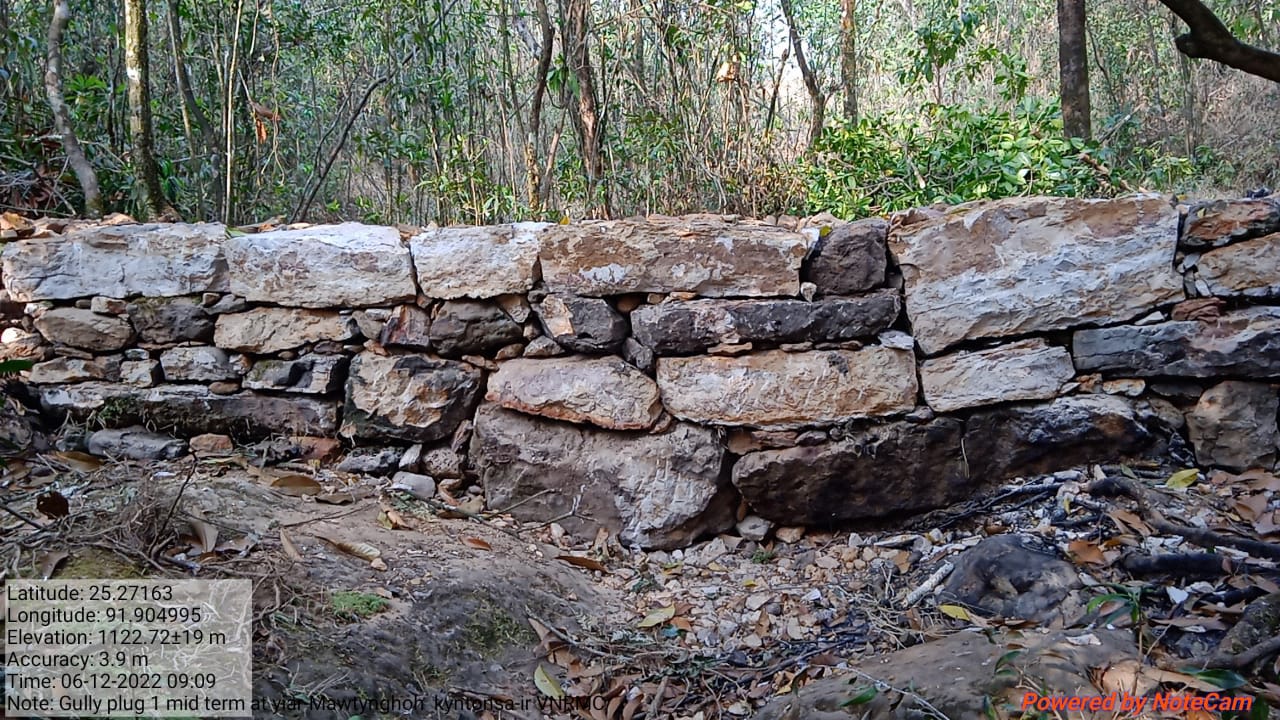

14. | Gully plug | Mawtynghoh | 21-Nov-22 | Ongoing | 75,910 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
Dug Out Pond | Kliariar Tngaw | 21-Nov-22 | Ongoing | 75,910 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
Gully plug | Mawtynghoh | 21-Nov-22 | Ongoing | 75,910 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
Spring chamber | Imyntoi | 11-Nov-22 | Ongoing | 78,248 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
Spring shed | Yiarkla | 2-Nov-22 | Ongoing | 54,276 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
RCC Check dam | Yiarkhla | 15-Sep-22 | 1-Nov-22 | 3,99,872 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
Afforestation | Kynton saiir | 14-Jul-22 | 10-Sep-22 | 3,81,690 |
Name of Intervention | Site Name | Start Date | Completion Date | Total Amount |
---|---|---|---|---|
RCC Check dam | Wah eir Dieng Liang | 29-Nov-21 | 05-Mar-22 | 2,95,967 |
